Budgets on Cost Codes for Projects

Add and edit Budgets for Cost Codes that belong to Projects. This allows you to view budgets and variances of costs for the budgets for these Projects.

Overview

Adding a new Cost code with a budget

Update the budget for a Cost code by editing the Initial value

Update budgets for Cost codes by exporting, editing and importing a spreadsheet

Review Cost code budgets

Cost code budget detail for a Project

Export Project / Cost code budgets

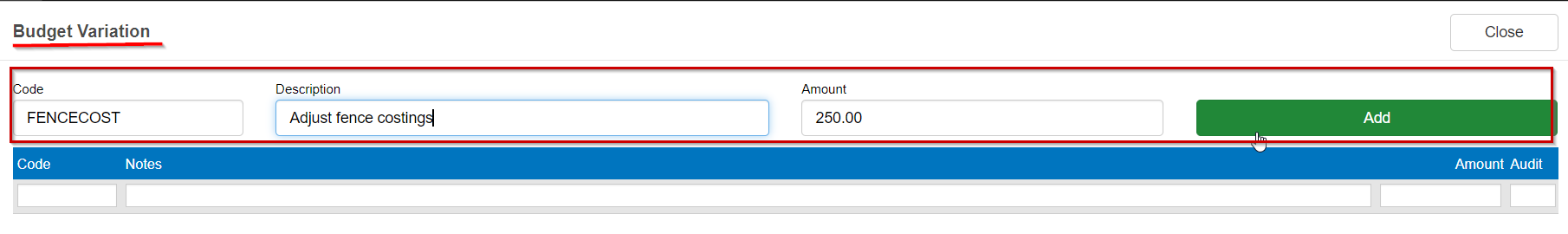

View and Import Variations


Overview

When adding or updating Cost codes, you can add figures to manage the budget for a Project.

You can also update an existing budget. This can be done for individual Cost codes, or for multiple Cost codes via the export/edit/import tool.

Here’s a video that walks you through the process of adding a cost code to a project:



Return to Top of Page



Adding a new Cost code with a budget


When creating a new Cost code, you are able to add a budget amount for the Cost code.

  • Start at Administration > Cost codes and click New Cost Code.
  • Add details for the Code, Description, Cost type, Project code, General ledger code and Budget amount.
  • Click Save.

Budgets and cost codes-replacement-1

Return to Top of Page



Update the budget for a Cost code by editing the Initial value

You can edit the budget for a Cost code by editing the initial value. Here’s a video that shows you how it works:





TIP: Editing the budget this way does not show as a budget variation. You'd use this option when you want to change the initial budget values, rather than retain the initial budget and show a variation. The value of any existing variations will be displayed beside the Variations button. If you need to create or edit a variation, use the variations area on the project.



NOTE: Only Users with an administration Security Role are able to edit the Initial budget values.

Users without this role may enter Variations.



  • Select the Cost code and double click it to edit.

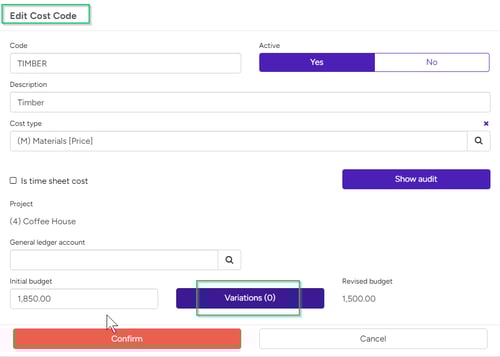

  • Edit the Initial Budget field for your new total budget amount.
  • Click Confirm.

Budgets and cost codes-replacement-2

Return to Top of Page


Update budgets for Cost codes by exporting, editing and importing a spreadsheet

A quick way to update budgets for multiple Cost codes is to export Cost codes, creating a spreadsheet. Edit the spreadsheet to update the budget figures and re-import it.

  • From the Administration > Cost codes menu:
  • Click Export / Import and select Export to spreadsheet.



Budgets and cost codes-replacement-5



This will create a spreadsheet file and place it in your downloads folder.

You can update the value for Initial Budget and Revised Budget. The field you choose to update may depend on whether you need to make a correction to an Initial Budget value, or whether you need to revise the budget due to a change in the project.

  • Open the file, and update either the InitialBudget column to change the Initial Budget, or the RevisedBudget column to change the Revised Budget, for those Cost codes that you wish to update.
  • Save the changes to your spreadsheet.
  • Return to the Cost codes screen, click Export / Import and then select Import from spreadsheet.
  • Browse for your spreadsheet, or drag it to the screen and click Upload.
You will see a message Import successful

Return to Top of Page


Review Cost code budgets

In the Projects screen, you can view the budgets and variations.

  • From the Administration > Projects menu:
  • Select the Project you wish to review, and click to the Details tab.

In the Budget section, figures are displayed for the Original Budget, Budget variations, Revised budget and Budgeted margin.



Budgets and cost codes-replacement-6

Return to Top of Page


Cost code budget detail for a Project

You can review the budget details by Cost code for the Project.

  • Remaining in the Project, click to the Cost codes tab.

This displays a summary of the Forecast costs for the Project in the top part of the screen and below that is one line for each Cost code on that Project.

Values for Budget, Variation and Revised budget are displayed as well as Committed, Spent and Remaining. The Committed value is taken from any Purchase orders that have been raised against that Project / Cost code. Once that Purchase order has been invoiced, the value is moved from Committed to Spent.



Budgets and cost codes-replacement-7

Return to Top of Page


Export Project / Cost code budgets

The details for the Project / Cost code budgets can be exported to a spreadsheet.

  • From the selected Project, click to the Cost Codes tab.
  • Click More, then click Export to Spreadsheet.

Budgets and cost codes-replacement-8

This will create the spreadsheet in your downloads folder, allowing you to report further on your Costs to Budgets figures for a Project.
